Skip to main content
Scheduler is delivered as a Polarion Rich Page widget. Everything the board shows — which work items load, what the rows stand for, which fields carry the dates — comes from the widget’s parameters, so placing the widget and configuring it is one continuous task.

Prerequisites

  • Scheduler installed and licensed on your Polarion server (see Installation)
  • A Polarion project that contains the work items you want to plan
  • Edit permission on the project’s Documents & Pages

Place the Widget on a Page

1

Create or open a Rich Page

Open your project and navigate to Documents & Pages. Select the space that should hold the board, click Expand Tools in the upper toolbar, then use the gear button and Create New to create an Info or LiveReport Page. Give it a title (for example, “Scheduler”) and create it.The new page opens in edit mode with the widget picker on the right-hand side. If you are returning to an existing page instead, click Expand Tools and then Edit to put it into edit mode.
2

Add the Scheduler widget

In the widget picker, select the Scheduler widget. It is tagged Plans, Work Items and Nextedy, so it appears under each of those categories.The widget loads onto the page and immediately renders a board using its default parameters: a timeline of day columns, one row per project user, and the Unplanned sidebar on the right.
3

Open the widget parameters

Select the Scheduler widget on the page and choose Edit widget parameters.The parameter editor lists the widget’s sections in this order:Data Mapping and Advanced are collapsed when the editor opens — expand them to reach their parameters.

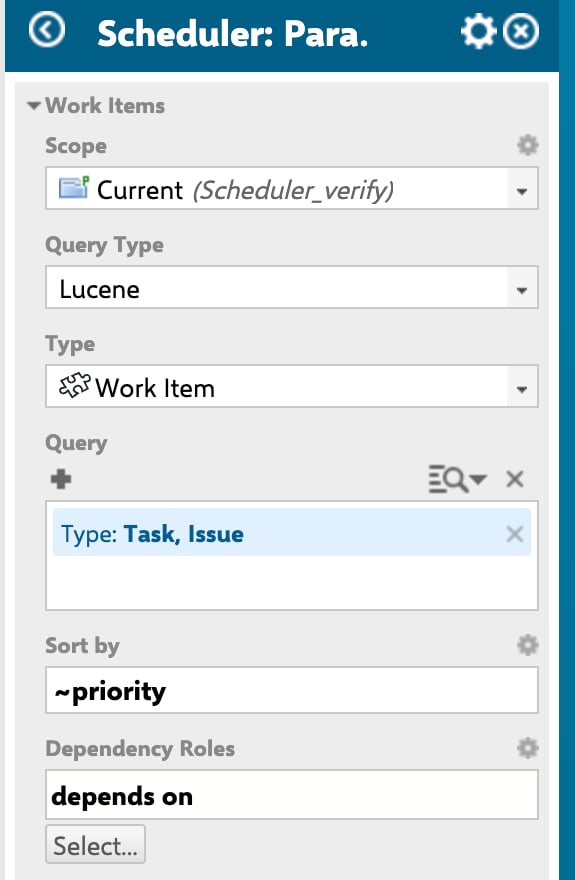

The Scheduler widget parameter panel showing the Work Items section: Scope set to Current, Query Type Lucene, Type Work Item, a query condition reading Type: Task, Issue, Sort by set to tilde-priority, and Dependency Roles set to depends on

The parameter editor opens on the Work Items section, which carries the query itself along with Sort by, Dependency Roles and Plans Type.

4

Apply and save the page

Apply your parameter changes, then save the page with Polarion’s page toolbar. Widget configuration lives on the page, so an unsaved page loses the configuration when you navigate away.
Saving the page and saving the schedule are two different things. The page must be saved to keep your parameter changes. Scheduling work on the finished board is saved automatically — the board has no Save control (see Schedule and Reschedule Tasks).

Select the Work Items

The Work Items section defines the population of the board. Build its query so it returns exactly the items you plan on this page — everything else on the board is derived from that set: the cards on the timeline, the contents of the Unplanned sidebar, and the per-day load on each row. Two neighbouring parameters in the same section are worth setting at the same time:
  • Sort by — the field the loaded items are ordered by.
  • Dependency Roles — the work item link role(s) that count as a dependency. Leave it empty and the board has no dependency features at all: the Add Link handle on a card stays hidden and the Show Dependencies toolbar button does not appear. See Link Task Dependencies.
Keep the query narrow. The Advanced section carries a Max Items cap on how many work items the board will load, and a broad query makes the board slower to read as well as slower to load.
A query that matches nothing does not produce a message. The board draws its rows as usual with no cards on them, and the footer reads “Items loaded: 0 / Scheduled: 0”. If the timeline looks empty, check the query first.

Set What the Rows Represent

Open Swimlanes (Rows) and set Assignment Type:
  • Users (Assignee) — one row per project user. This is the default. The User Role parameter in Advanced decides which users get a row.
  • Enumeration Field — one row per option of an enumeration field. Selecting it reveals Field ID, which defaults to team.
Both modes are covered step by step, together with the fields that cannot be used as rows and the error the board shows for them, in Configure Swimlanes.

Map the Dates

Expand Data Mapping. It holds three parameters and you set exactly two of them: Which two you fill in gives you three working modes:
  • Start Field + End Field — both ends of the bar are read from, and written back to, date fields. This is the out-of-the-box mapping.
  • Start Field + Duration Field — the bar starts at the start date and runs for the mapped duration.
  • End Field + Duration Field — the bar ends at the end date and its length comes from the mapped duration.
The mapped fields must exist on the work item types your query returns, and the account using the board needs write access to them — these are the fields the board writes when you drag a task.
The mapping also determines how a reader changes a task’s length: bars on the board cannot be resized. See Schedule and Reschedule Tasks and Dates, Duration and Effort.

Choose How Effort Is Read

Plans Type, in the Work Items section, selects which of Polarion’s time-tracking values the board treats as a task’s effort. It offers three options:
  • Initial Estimate
  • Remaining Estimate
  • Remaining Estimate + Time Spent
Effort does real work on the board: it appears on the right-hand fields line of each card, it drives the per-day load markers on the rows, and it sets the length of an item dropped from the sidebar. Capacity and Load explains how effort turns into load.

Set Up the Unplanned Sidebar

The Unplanned Sidebar section configures the backlog panel on the right of the board. Readers can hide and show the panel at any time with the Show unscheduled items in sidebar toolbar button, which is on by default. Its filters, search box and item count are covered in Filter the Unplanned Sidebar.

Adjust the Card Height

Card Height lives in the Advanced section and is a number of pixels; the default is 50. Raise it when your cards carry long titles or several tooltip-worthy fields and the text is cramped; lower it to fit more rows on screen at once.

Choose the Tooltip Fields

Tooltip Fields, in the Work Items section, lists the work item fields shown as label-and-value lines when a reader hovers a task bar. Out of the box it contains Project, Type, Status and Assignee(s). The tooltip always leads with the work item’s title and the task’s date range; your Tooltip Fields are appended underneath. Pick the two or three fields a planner needs without opening the work item — the tooltip is the fastest read on the board.
Sidebar Fields, right above it, does the same job for the cards in the Unplanned sidebar. It starts with Title only, so add the fields that help a planner decide where an item belongs before dragging it out.

Verification

With the page saved, reload it and check the board:
  1. Rows appear for the resources you configured — project users, or the options of your enumeration field.
  2. Scheduled work items appear as bars in the day columns, and unscheduled ones appear as cards under the Unplanned header.
  3. The footer reads “Items loaded: N / Scheduled: M” with N matching the size of your query result, followed by “Timeline range: <start> - <end>” and the Scheduler version.
  4. Hovering a bar shows the work item title, the date range, and the fields you listed under Tooltip Fields.
  5. Dragging a card out of the sidebar onto a row schedules it and the change persists without any Save action.
If rows are missing or an error appears in place of them, the Swimlanes (Rows) configuration is the place to look — see Configure Swimlanes.
