Prerequisites
Before you begin, confirm that your board meets the following requirements:- The Nextedy PLANNINGBOARD is configured with Teams Service enabled (
useTeamsService = true). - Team Assignments are set up for the project (members have assignments with start and end dates).
- Swimlanes use the Users (Assignee) assignment type, with rows derived from Team Assignments.
- You are running Planningboard version 25.12.0 or later.

How it works
activeTeamAssignmentsInPlanRangeOnly=true is set, Planningboard calculates the combined date span of all Plans visible on the board and checks each team member’s assignments. Members whose assignments have no overlap with that span are hidden. Any work items already assigned to a hidden member are moved automatically to the Not Assigned / Other swimlane.
Steps
1. Open Polarion Administration Configuration Properties
In Polarion, navigate to: Administration > Configuration Properties2. Add the property
Add the following property to your configuration:3. Save and reload
Save the configuration. Planningboard will apply the filter on the next board load — no server restart is required.4. Verify the result
Reload the Planningboard. Users who have no Team Assignments overlapping the date range of the currently shown Plans should no longer appear as swimlane rows. Any cards that were in their rows will have moved to the Not Assigned / Other swimlane.Configuration example
A typical setup combining Teams Service with plan-range filtering:Worked example

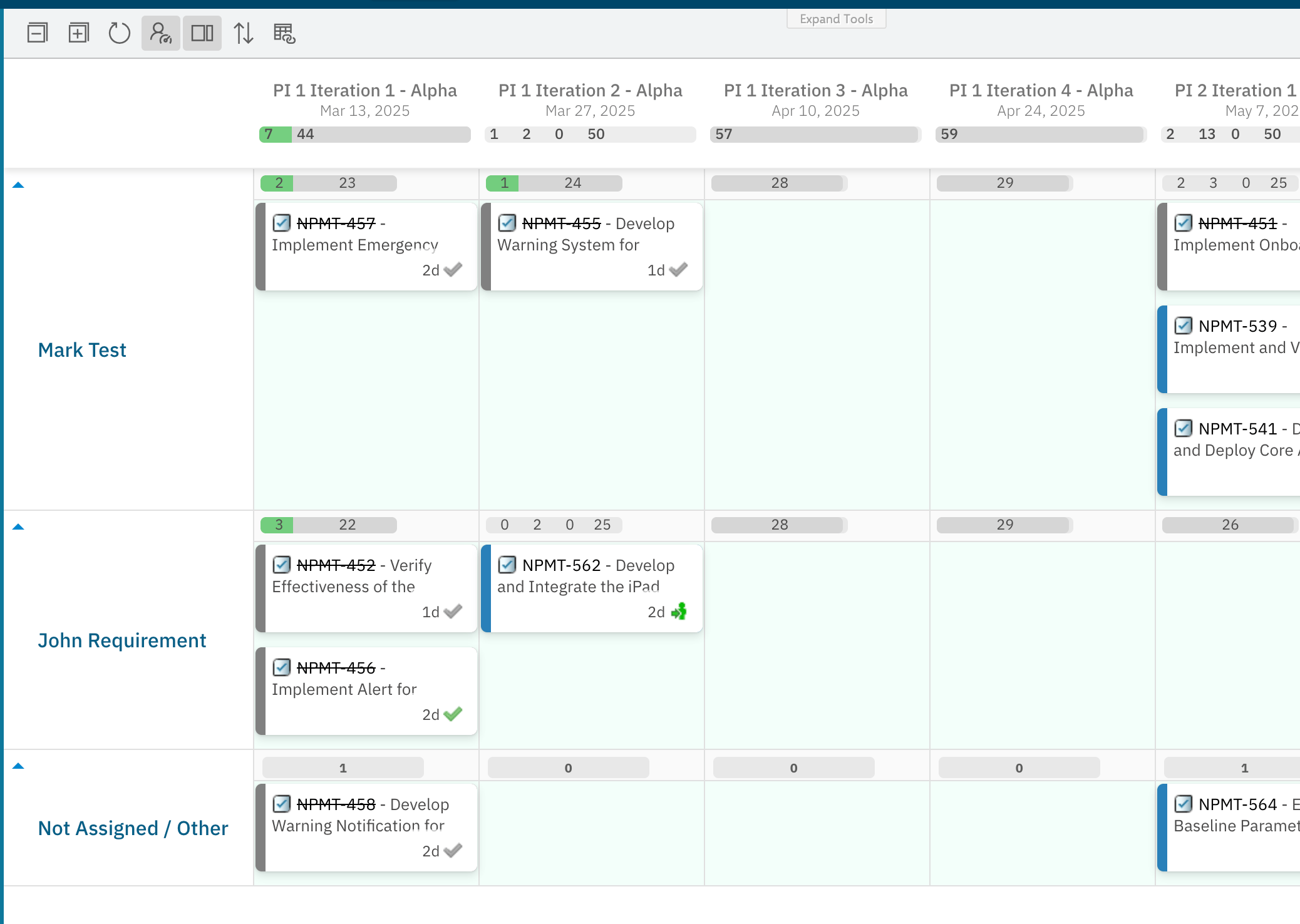

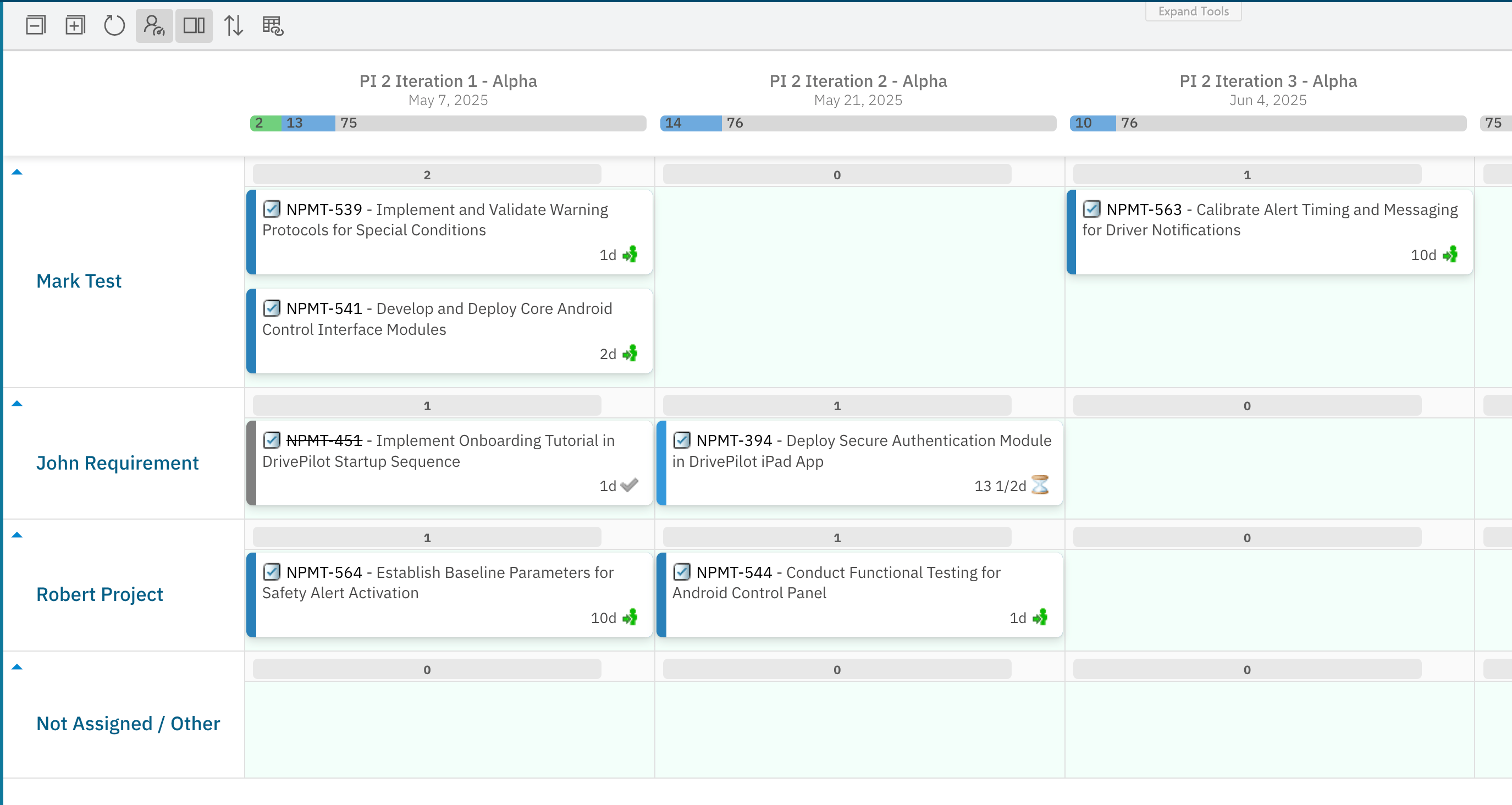

Scenario: Team Alpha is planning for three sprints (Sprint 10–12, covering January to mid-February). The board shows swimlanes for all team members. Mark Test left the team in December and has no assignment for this window. Before enabling the property: The board shows a swimlane for Mark Test even though he has no capacity in the planning window. Tasks that slip into his row are unlikely to be completed.
activeTeamAssignmentsInPlanRangeOnly=true:

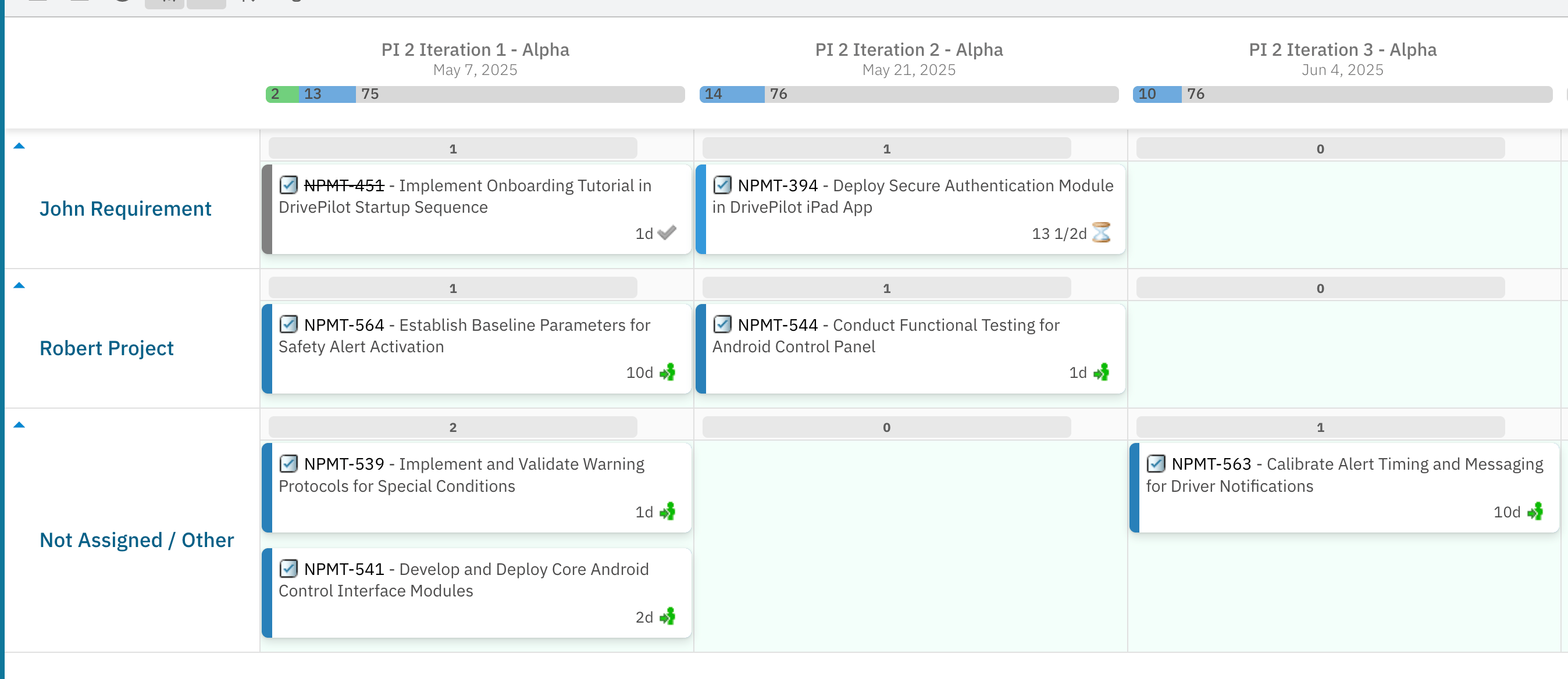

Mark Test’s swimlane disappears. Any tasks that were assigned to him move to Not Assigned / Other, making the capacity gap visible and prompting reassignment.

Limitations
- This feature requires Planningboard 25.12.0 or later. Earlier versions do not support plan-range-aware filtering.
- The filter is applied at board load time — it reflects the Plans currently shown. If you scroll the board to display a different Plan range, the visible swimlane rows update accordingly on the next load.
- Items assigned to a hidden member are surfaced in Not Assigned / Other, not silently dropped. Review that swimlane after enabling the filter to reassign any affected cards.
- This behavior applies only to swimlanes derived from Team Assignments. User swimlanes based on project role membership (not Teams Service) are not affected.
Verification
After completing the steps above, reload the Planningboard. You should see:- Swimlane rows only for team members whose Team Assignments overlap the date range of the Plans shown.
- A Not Assigned / Other swimlane at the bottom containing any cards previously belonging to hidden members.
- No swimlane row for members whose assignments fall entirely before or after the current Plan window.
See also
- User and Assignee Swimlanes — configure the Users (Assignee) assignment type
- Filter Swimlanes by Team — restrict swimlane rows to a specific team
- Configure Swimlanes (Rows) — full swimlane configuration reference
- Set Up Teams Service — prerequisite for Team Assignment–based filtering
- Track Team Capacity — use capacity bars alongside swimlane filtering
