Prerequisites
- A dedicated calendar project with work item calendars already configured (see Set Up Work Item Calendars)
- Access to Administration > Configuration Properties in both the calendar project and each consuming project
1
Identify the Calendar Project Settings
In your calendar project, find the following values:
- Project ID: The Polarion project ID of the calendar project (visible in the URL or project settings)
- Global Calendar Work Item ID: The ID of the Calendar-type work item used as the global (company) calendar
2
Configure the Calendar Project
Add these properties in the calendar project under Administration > Configuration Properties:Replace
CalendarProject with the actual project ID and CAL-1 with the actual global calendar work item ID.3
Configure Each Consuming Project
In every project that should use the shared calendar, add the same properties under Administration > Configuration Properties:
4
Enable Working Calendars in Each Widget
In each consuming project’s Gantt widget, navigate to the Working Calendars section in the widget parameters:
The Gantt looks up each resource’s calendar in the shared calendar project by matching the Assignee field on Calendar work items to the resource’s Polarion user ID.

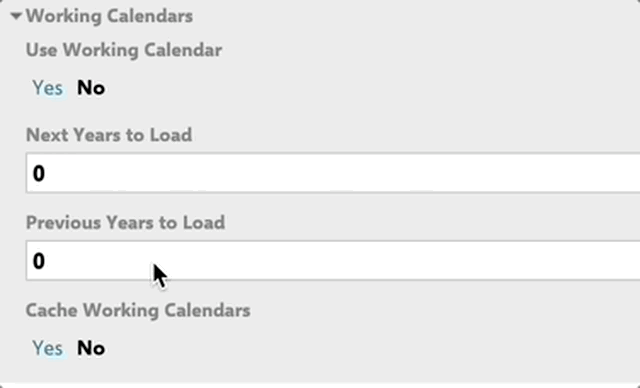

- Set Use Working Calendar to Yes
- Set Load User Calendars to Yes
- Optionally enable Load Team Assignments for team-scoped capacity

5
Enable Calendar Caching (Recommended)
Cross-project calendar resolution involves querying work items in another project, which can be slow on large installations. Enable caching to improve performance:
How Calendar Resolution Works
When the Gantt loads in a consuming project:- The Gantt reads
nextedy.gantt.workitemCalendar.projectIdto determine the source project - For each resource, it searches for a Calendar work item in the source project where the Assignee matches the user and the From/To date range contains today

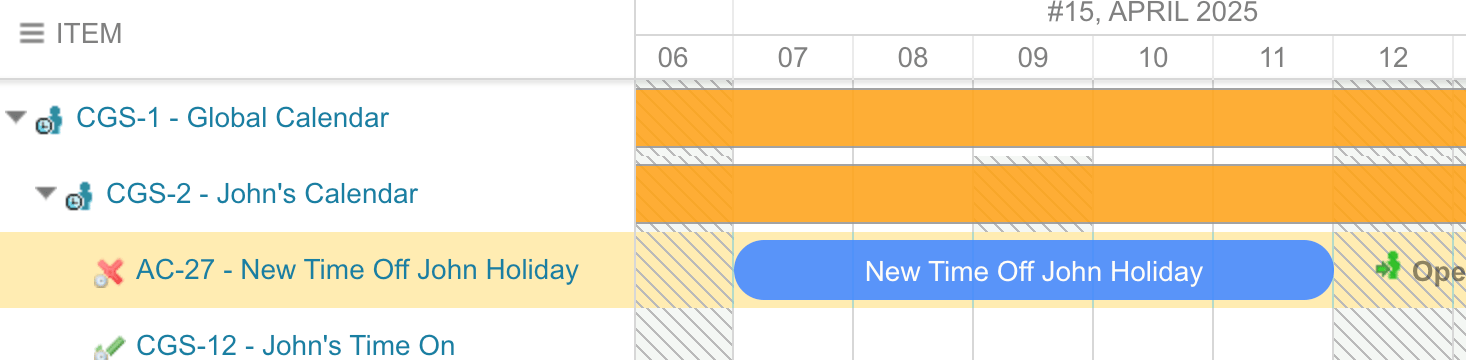

- If a user calendar is found, it loads the regular working hours and all linked exceptions (Time Off, Time On, Tweak) via the affects link role
- If no user calendar is found, the global calendar (specified by
nextedy.gantt.workitemCalendar.globalID) is used as the fallback

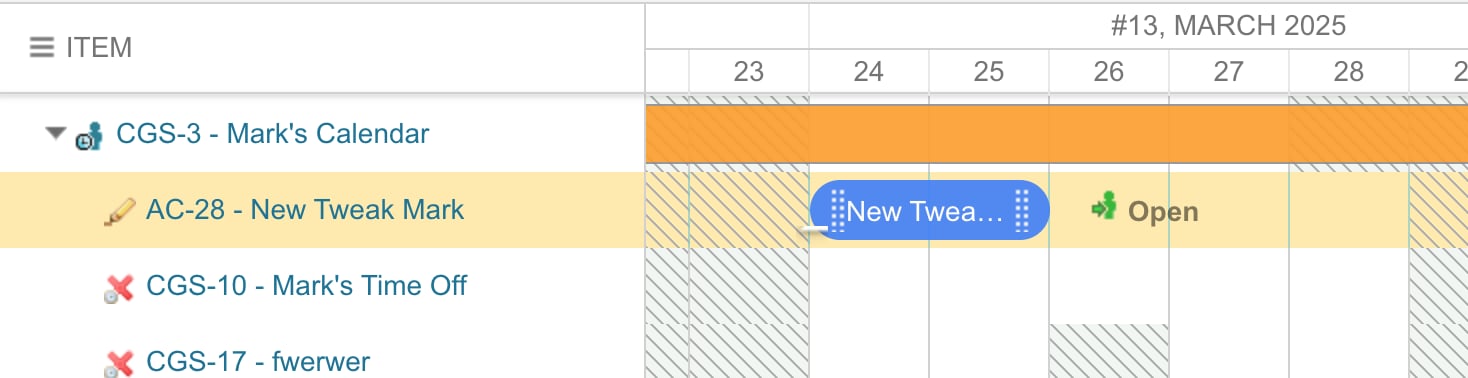

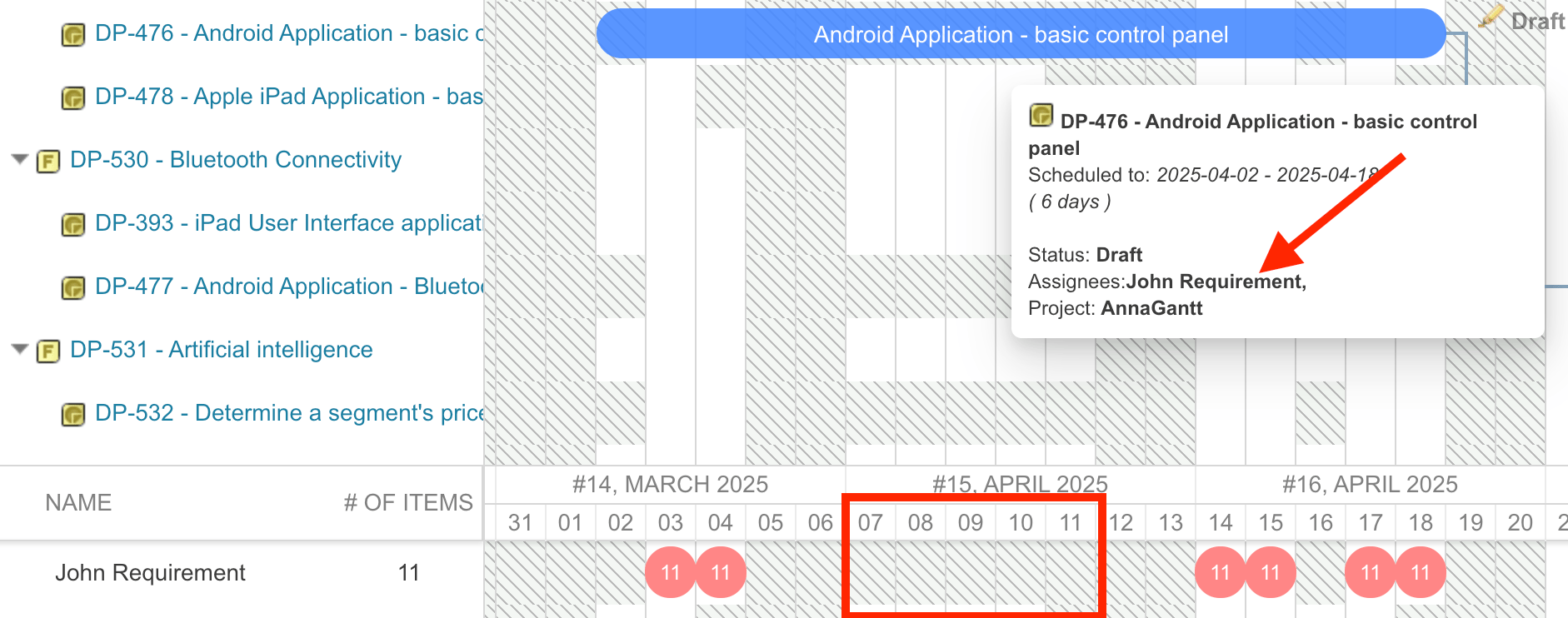

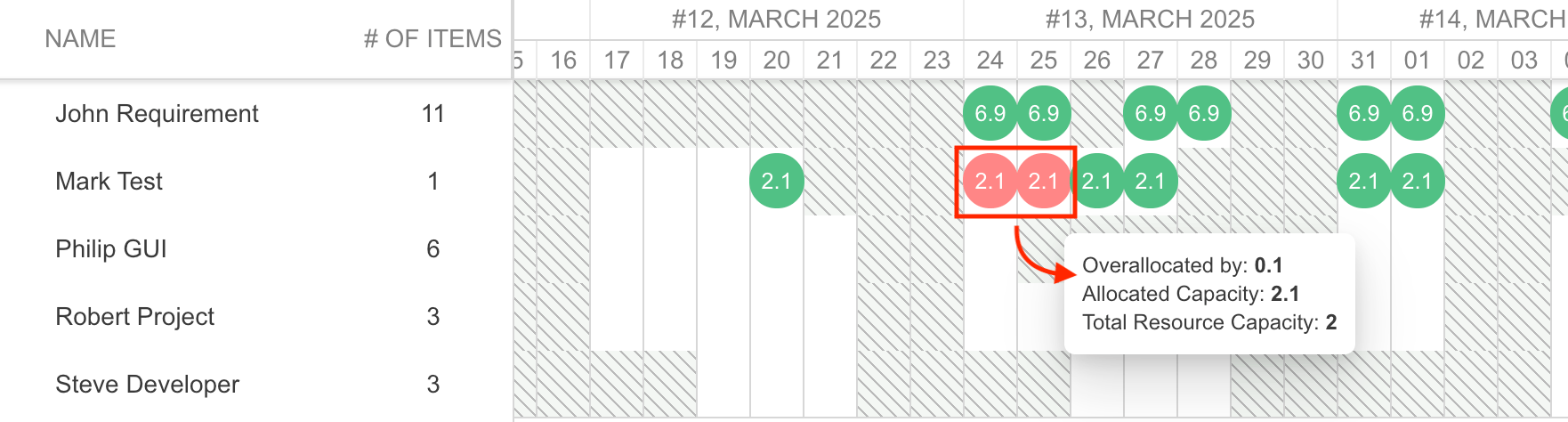

Verify
