Skip to main content

The Core Idea

Imagine a project with three tasks connected in sequence: Design, Build, and Test. If Design slips by two days, Build must also start two days later, which pushes Test by the same amount. Without auto-scheduling, you would need to manually adjust each task. With auto-scheduling enabled, moving Design automatically shifts Build and Test to maintain the dependency constraints. Auto-scheduling updates the start date of a successor task according to the end date of its predecessor each time a change occurs. This allows you to maintain the project schedule by specifying relationships between tasks with no need to set dates manually.
diagram
When Design is moved to Jan 3 - Jan 7, auto-scheduling adjusts:
  • Build shifts to Jan 8 - Jan 14
  • Test shifts to Jan 15 - Jan 19

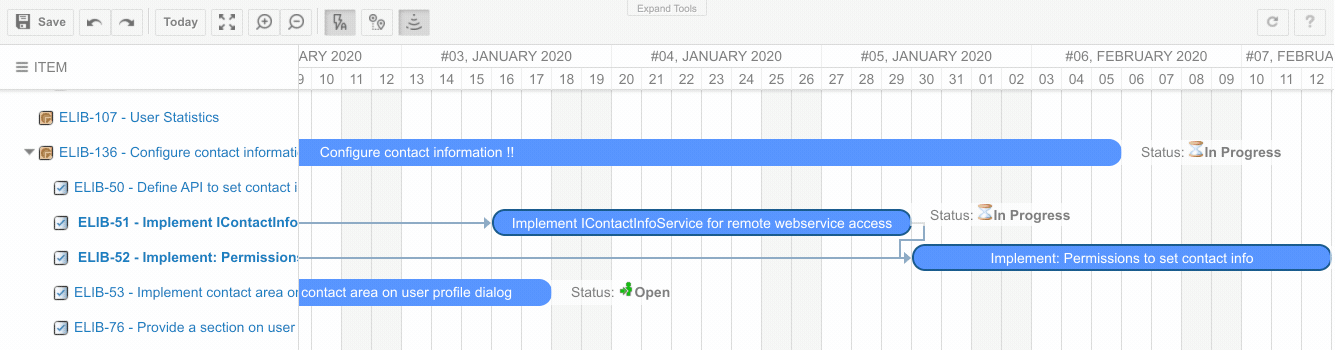

Dragging the first task on the Gantt timeline; the dependent task automatically shifts to keep its start aligned with the predecessor's end

How It Works

Auto-scheduling is triggered only when you change a task or modify a dependency link. It does not continuously run in the background. When you drag a task bar, resize it, or edit dates in the lightbox, the Gantt evaluates all downstream dependencies and adjusts successor dates to satisfy the constraints. The propagation follows dependency link types:
Dependency typeConstraint
Finish-to-Start (FS)Successor starts after predecessor finishes
Start-to-Start (SS)Successor starts when predecessor starts
Finish-to-Finish (FF)Successor finishes when predecessor finishes
Start-to-Finish (SF)Successor finishes when predecessor starts
The most common type is Finish-to-Start (FS), where the successor cannot begin until the predecessor is complete.
When auto-scheduling is disabled and a successor’s start date is planned before the predecessor finishes, the Gantt highlights the conflict visually. This helps you spot scheduling violations even in manual scheduling mode.

Enabling and Controlling Auto-Scheduling

Auto-scheduling is controlled at the server level via the administration property nextedy.gantt.default.auto_scheduling. When set to true, the Gantt opens with auto-scheduling enabled by default. Users can toggle auto-scheduling on and off at runtime using the toolbar toggle button. This allows switching between automatic constraint enforcement and manual date editing within the same session.
Gantt toolbar with the auto-scheduling toggle button used to switch automatic scheduling on and off

Per-Task Overrides

In complex projects, you may want auto-scheduling for most tasks but need certain tasks (such as milestones or fixed-date deliverables) to remain pinned. The Gantt supports per-task override flags:
  • enforceAutoMode — Forces auto-scheduling for a specific task, even if the global setting is off
  • blockAutoMode — Prevents auto-scheduling from moving a specific task, even if the global setting is on
These flags enable mixed scheduling strategies where top-level milestones remain fixed while lower-level tasks are automatically adjusted.
When combining auto-scheduling with parent-child hierarchies, the behavior can become complex. Moving a parent task propagates to children, which in turn may trigger dependency propagation on their successors. If you need to prevent auto-scheduling on top-level work items while allowing it on lower levels, consider using a combination of readonly mode for top-level items and per-task blockAutoMode flags.

Interaction with Drag Children

The dragChildren configuration controls whether child tasks move together with their parent when the parent is dragged. When both dragChildren and auto-scheduling are enabled:
  1. Dragging the parent moves all children by the same offset
  2. Auto-scheduling then recalculates any successors of those children
This two-step behavior means that moving a parent task can cascade changes throughout the project schedule.

Interaction with Working Calendars

When working calendars are enabled, auto-scheduling respects non-working days. If a predecessor finishes on Friday and the successor has a Finish-to-Start dependency, the successor will start on Monday (skipping the weekend) rather than Saturday. This applies to all calendar exceptions including holidays and per-user off days.

What Auto-Scheduling Does Not Do

Auto-scheduling operates on the client side during the current editing session. It does not:
  • Run automatically when Polarion data changes outside the Gantt (e.g., another user modifies dates via the Polarion work item form)
  • Detect concurrent editing conflicts — the last save wins
  • Automatically resolve resource overallocation
Auto-scheduling recalculates dates based on dependency constraints only. For resource capacity analysis, see Resource Load Calculation Modes.
